EVM Management: A Comprehensive Guide

F.Radio 43 views
EVM Management: A Comprehensive Guide

EVM Management: A Comprehensive Guide

Hey guys! Today, we’re diving deep into something super crucial for any project’s success: EVM Management . Now, I know ‘EVM’ might sound a bit technical, but trust me, understanding this is like having a superpower for keeping your projects on track, on budget, and exactly where they need to be. We’re going to break down what EVM management is, why it’s an absolute game-changer, and how you can actually do it. So, grab your favorite beverage, get comfy, and let’s unravel the magic of Earned Value Management!

What Exactly is EVM Management, Anyway?

Alright, let’s kick things off by defining EVM management . At its core, EVM, or Earned Value Management, is a project management technique that helps you measure project performance and progress in an objective manner. Think of it as a way to integrate your project’s scope, schedule, and cost baselines. Instead of just looking at how much money you’ve spent or how much time has passed, EVM tells you the value of the work you’ve actually completed .

Imagine you’re building a house. You’ve spent \(100,000 so far. Now, you could just say, "Okay, we've spent \) 100k.” But EVM management asks, “For that $100k, how much of the house is actually finished ?” If you’ve only completed 30% of the house, but you’ve already blown through 50% of your budget, you’ve got a problem. Conversely, if you’ve finished 60% of the house and only spent 40% of the budget, you’re doing great! This is the fundamental power of EVM – it gives you that objective insight into your project’s true status.

So, when we talk about EVM management , we’re talking about a systematic approach to planning, analyzing, and controlling project work. It’s not just about tracking tasks; it’s about understanding the value those tasks deliver relative to the plan. This involves three key elements:

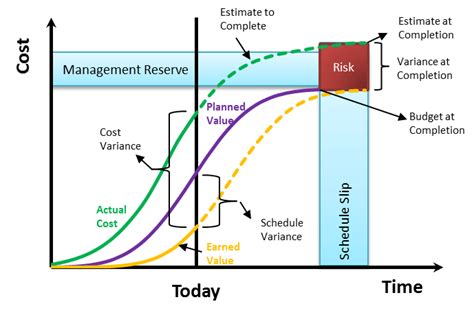

  • Planned Value (PV): This is the budgeted cost of the work scheduled to be completed up to a specific point in time. It’s basically what you planned to spend by now.
  • Earned Value (EV): This is the budgeted cost of the work actually performed up to that specific point in time. This is the crucial part – the value of what you’ve earned .
  • Actual Cost (AC): This is the total cost incurred for the work performed up to that specific point in time. This is the money you’ve actually spent .

By comparing these three figures, EVM management allows you to answer critical questions like: Are we ahead or behind schedule? Are we over or under budget? And, perhaps most importantly, what is our projected final cost and completion date based on current performance?

It’s a proactive approach, guys. Instead of waiting until the end of the project to discover you’re way off track, EVM management provides early warnings, allowing you to take corrective actions before things get out of hand. This makes it an indispensable tool for project managers, stakeholders, and anyone who wants to ensure project success. It’s about moving from reactive firefighting to proactive control, and that’s a massive win for any project.

Why is EVM Management a Total Game-Changer?

Okay, so why should you even bother with EVM management ? What makes it so special? Well, let me tell you, this isn’t just another buzzword in the project management world; it’s a proven methodology that delivers tangible benefits. If you’re looking to boost your project’s predictability, control costs, and keep stakeholders happy, EVM management is your secret weapon.

First off, let’s talk about early problem detection . This is arguably the biggest perk of using EVM. Traditional methods often only tell you how much you’ve spent or how much time has elapsed. But EVM management gives you a much deeper insight. By comparing your planned progress (PV) with your actual progress (EV) and actual costs (AC), you can identify variances early . For example, if your Earned Value (EV) is consistently lower than your Planned Value (PV), it signals that you’re behind schedule. If your Actual Cost (AC) is higher than your Earned Value (EV), you’re over budget. These aren’t just numbers; they’re flashing red lights that tell you, “Hey, something’s not right here, and you need to look into it now !” This early warning system is invaluable because it gives you the time to implement corrective actions before minor issues snowball into major crises. Imagine catching a small plumbing leak early in your house construction versus finding out the whole foundation is waterlogged – EVM management is like having that early leak detector.

Secondly, improved forecasting and decision-making . Because EVM management provides objective performance data, it allows for much more accurate forecasting. Metrics like the Schedule Performance Index (SPI) and Cost Performance Index (CPI) give you a clear indication of your project’s momentum. SPI = EV/PV tells you how efficiently you’re progressing against the plan (a value greater than 1 means you’re ahead of schedule, less than 1 means you’re behind). CPI = EV/AC tells you how efficiently you’re using your budget (a value greater than 1 means you’re under budget, less than 1 means you’re over budget). Armed with these indices, you can project the likely completion date and final cost of your project with much greater confidence. This means you can make better, data-driven decisions about resource allocation, scope adjustments, or the need for additional funding. No more guessing games, guys!

Thirdly, enhanced communication and stakeholder confidence . Projects often involve multiple stakeholders – clients, senior management, team members, etc. Keeping everyone informed and aligned can be a challenge. EVM management provides a common, objective language to discuss project status. When you can present clear, quantifiable data on performance and forecasts, it builds trust and confidence among stakeholders. They can see that the project is being managed proactively and that potential issues are being addressed. This transparency is key to maintaining positive relationships and ensuring continued support for the project. Instead of vague updates, you can say, “Based on our current CPI of 1.1 and SPI of 0.9, we forecast a completion cost of $X and a revised completion date of Y,” which is far more reassuring than simply saying “we’re a bit behind schedule and over budget.”

Finally, better scope and cost control . EVM management inherently ties scope completion to cost. It forces you to define your work scope clearly and to track precisely what has been accomplished. This helps prevent scope creep – the uncontrolled expansion of project requirements – which is a notorious killer of budgets and schedules. By focusing on the earned value of the work, you’re always asking, “What have we delivered for the money spent?” This discipline helps maintain focus on the agreed-upon scope and keeps costs in check. It provides a solid framework for managing changes, ensuring that any additions to scope are properly evaluated for their impact on time and budget before being approved.

In essence, EVM management transforms project tracking from a passive reporting exercise into an active, analytical process. It provides the insights needed to steer your project towards success, rather than just observing its trajectory. It’s about control, predictability, and delivering value effectively.

How to Implement EVM Management: A Practical Approach

Now for the good stuff, guys: how do you actually do EVM management ? It might seem daunting at first, but breaking it down into manageable steps makes it totally achievable. The key is to have a solid plan, track your progress diligently, and use the data to inform your decisions. Let’s walk through the essential steps:

1. Establish a Solid Project Baseline: This is your foundation, and it’s absolutely critical. Without a clear baseline, you can’t measure anything effectively. This involves:

*   ***Defining the Scope:*** What exactly are you delivering? Break down the project into manageable tasks or work packages. This is often done using a Work Breakdown Structure (WBS).
*   ***Developing the Schedule:*** Sequence your tasks and assign realistic durations. This creates your project timeline.
*   ***Creating the Cost Baseline:*** Assign a budget to each task or work package. Summing these up gives you your total project budget. This is where you define your Planned Value (PV) over time.

This integrated baseline – scope, schedule, and cost – is what EVM management uses for comparison. It needs to be realistic and agreed upon by all key stakeholders. It’s your roadmap!

2. Track Progress and Actual Costs: This is the ongoing, hands-on part of EVM management . As the project progresses, you need to meticulously track:

*   ***Actual Progress:*** How much of each task or work package has actually been completed? This is where you determine your Earned Value (EV). This might involve physical measurement, completion of milestones, or percentage complete estimates agreed upon beforehand.
*   ***Actual Costs (AC):*** How much money has actually been spent on each task or work package? This means collecting all invoices, timesheets, and expense reports.

Accuracy here is paramount. If your tracking is off, your EVM data will be unreliable, leading to flawed analysis and potentially bad decisions.

3. Calculate Key EVM Metrics: Once you have your baseline and your tracking data, you can start calculating the core EVM metrics. At regular intervals (weekly, bi-weekly, monthly – depending on your project pace), you’ll calculate:

*   ***Schedule Variance (SV):*** SV = EV - PV. A positive SV means you're ahead of schedule; a negative SV means you're behind.
*   ***Cost Variance (CV):*** CV = EV - AC. A positive CV means you're under budget; a negative CV means you're over budget.
*   ***Schedule Performance Index (SPI):*** SPI = EV / PV. SPI > 1 is good (ahead of schedule), SPI < 1 is bad (behind).
*   ***Cost Performance Index (CPI):*** CPI = EV / AC. CPI > 1 is good (under budget), CPI < 1 is bad (over budget).

These four metrics are the bread and butter of EVM management. They give you an immediate, objective snapshot of your project’s health.

4. Analyze Variances and Forecast: This is where the real intelligence comes from EVM management . Don’t just calculate the numbers; understand what they mean.

*   ***Analyze Variances:*** If SV or CV are negative, dig into *why*. Was there a specific issue, a resource problem, an unforeseen complication? Identify the root cause.
*   ***Forecast Future Performance:*** Use your performance indices (SPI and CPI) to forecast the Estimate at Completion (EAC) and Estimate to Complete (ETC). Common formulas include:
    *   EAC = AC + (BAC - EV) / CPI (Assumes past performance continues)
    *   EAC = AC + ETC (where ETC is calculated based on new estimates)
    *   EAC = BAC (if you believe you can bring costs back in line)
*   ***Determine if Re-planning is Needed:*** Based on your analysis and forecasts, do you need to adjust your plan? This could involve reallocating resources, adjusting the schedule, seeking additional funding, or even descoping certain elements.

5. Take Corrective Action and Re-baseline (If Necessary): Once you understand the situation, you need to act!

*   ***Implement Corrective Actions:*** Address the root causes of negative variances. This might involve additional training, improving communication, procuring new resources, or renegotiating with suppliers.
*   ***Monitor and Control:*** Keep a close eye on the impact of your corrective actions. Continue tracking and calculating EVM metrics.
*   ***Re-baseline:*** If significant changes occur that fundamentally alter the project baseline (e.g., major scope changes approved by stakeholders), you may need to formally re-baseline the project. This creates a new reference point for measuring performance going forward.

Implementing EVM management requires discipline and commitment, but the payoff in terms of project control and success is immense. It transforms your project management from guesswork to a science. Start small if you need to, perhaps on a pilot project, and build your team’s proficiency. The consistency in applying these steps is key to unlocking the full power of EVM.

Common Pitfalls in EVM Management and How to Avoid Them

Even with the best intentions, EVM management can sometimes go sideways. Lots of folks run into similar issues, so let’s talk about some common pitfalls and how you can steer clear of them. Knowing these traps beforehand can save you a lot of headaches down the line, guys!

One of the biggest culprits is inaccurate or incomplete baselines . Remember how we talked about the project baseline being the foundation? Well, if that foundation is shaky, everything built on top of it will be unstable. This often happens when baselines are created too quickly, without proper stakeholder buy-in, or based on overly optimistic estimates. How to avoid it: Spend ample time defining your scope, schedule, and budget. Involve the right people – subject matter experts, team leads, and even key stakeholders – in the planning process. Ensure that estimates are realistic and that contingency is built in where appropriate. A well-defined, agreed-upon baseline is your best defense against future variance issues.

Another common trap is inconsistent data collection . If your team isn’t diligently and accurately tracking actual costs and progress, your EVM metrics will be garbage in, garbage out. This could be due to a lack of clear procedures, insufficient training on tracking tools, or a perception that tracking is just ‘busy work.’ How to avoid it: Implement clear, standardized procedures for tracking progress and costs. Provide adequate training to your team members on why this data is important and how to collect it accurately. Make it part of the regular project rhythm. Regularly audit your data for accuracy and consistency. If possible, use project management software that automates some of this data capture.

Then there’s the issue of not acting on the data . Calculating EVM metrics is only half the battle; the real value comes from using that information to make decisions and take action. Some project managers get bogged down in the calculations and forget to analyze the variances or implement corrective actions. They might see a negative CV or SPI and just note it down without exploring the cause or planning a response. How to avoid it: Schedule regular review meetings specifically to discuss EVM performance. Make it a mandatory agenda item. Empower your team to identify variances and propose solutions. Develop a clear process for escalating issues and making decisions based on the EVM analysis. Remember, EVM is a tool for control , not just reporting.

Misunderstanding or misusing EVM formulas is another pitfall. There are various ways to calculate forecasts (EAC, ETC), and using the wrong formula for a specific situation can lead to wildly inaccurate predictions. For instance, assuming past performance will continue indefinitely when significant changes have occurred is a common mistake. How to avoid it: Ensure your team has a solid understanding of the different EVM metrics and formulas. Train them on when and how to apply them correctly. Understand the assumptions behind each formula and recognize when a situation might require a different approach, such as updating the estimate based on current realities rather than just extrapolating past performance.

Finally, over-complicating EVM can be a killer. Trying to implement every single EVM metric and report from day one, especially on smaller or less complex projects, can overwhelm the team and lead to resistance. How to avoid it: Start with the core metrics (PV, EV, AC, SV, CV, SPI, CPI). As your team gains experience and the project complexity warrants it, you can introduce more advanced techniques. Tailor your EVM implementation to the specific needs and size of your project. The goal is to gain useful insights, not to create an administrative burden.

By being aware of these common pitfalls and proactively addressing them, you can significantly increase the effectiveness of your EVM management efforts and ensure your projects stay on track, within budget, and ultimately achieve their goals. It’s all about smart planning, diligent execution, and insightful analysis, guys!

Conclusion: Master EVM Management for Project Triumph

So there you have it, folks! We’ve journeyed through the world of EVM management , uncovering what it is, why it’s an absolute must-have for any serious project, and how you can practically implement it. Remember, EVM isn’t just about crunching numbers; it’s about gaining clarity , achieving control , and ensuring predictability in your projects. It’s the difference between flying blind and navigating with a sophisticated GPS.

By establishing a robust baseline, diligently tracking your progress and costs, calculating those vital EVM metrics (like CPI and SPI), and, most importantly, acting on the insights you gain, you are setting yourself up for project success. You’re moving from a reactive, ‘hope-for-the-best’ approach to a proactive, data-driven strategy. This empowers you to identify potential issues early, make informed decisions, communicate effectively with stakeholders, and ultimately deliver your projects on time and within budget.

Don’t shy away from EVM management because it sounds complex. Start with the basics, stay consistent, and focus on understanding the story the numbers are telling you. Avoid those common pitfalls we discussed, and you’ll be well on your way to mastering this powerful technique. It’s an investment in your project’s future and a skill that will make you a far more effective project manager.

Go forth, implement EVM management, and watch your projects transform from potential headaches into triumphs. Happy managing, guys!
